Modernising Edmonton EcoPark

The existing plant has served north London well for nearly 50 years, and has diverted more than 21 million tonnes of the non-recyclable waste which would otherwise have gone to landfill. It’s had multimillion-pound investments over the decades but is reaching the end if its useful life and we are now investing in a replacement.

Waste forecast for the future shows the amount of waste we create will increase in north London, even with our positive action to reduce and recycle. We also need to divert as much waste as possible away from landfill. The new facility will manage up to 700,000 tonnes a year at a peak by 2051, even if we reach our 50% household waste recycling target. We expect to send virtually no waste to landfill.

We save carbon dioxide (the equivalent of 215,000 tonnes each year), use less space and recover valuable resources which would otherwise be lost if this waste was sent to landfill. None of the alternative ways to treat non-recyclable waste are proven at the scale we need in north London or for such a low cost. Therefore, we have chosen the most cost-effective option available with today’s most advanced and proven technology for treating non-recyclable waste.

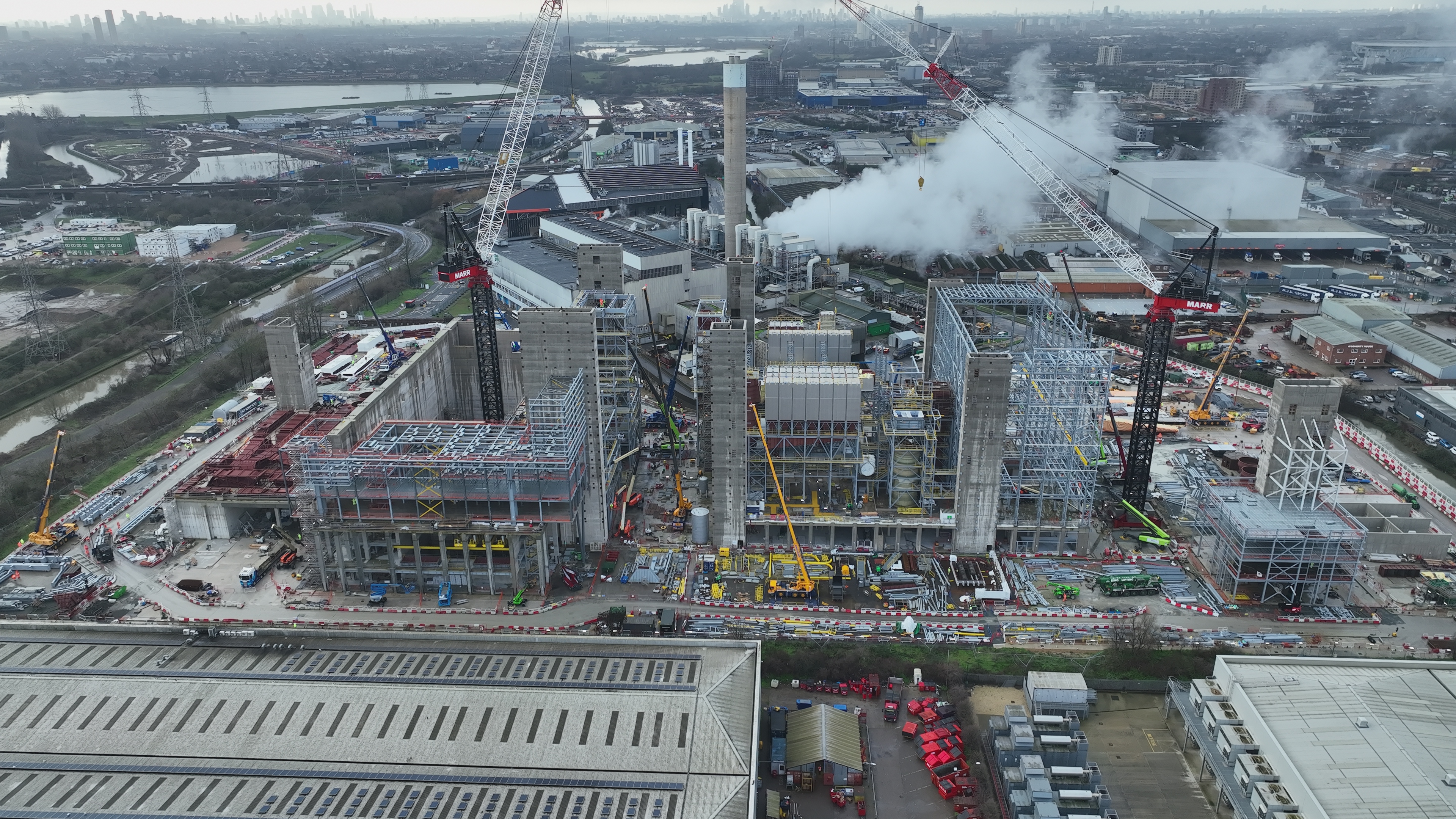

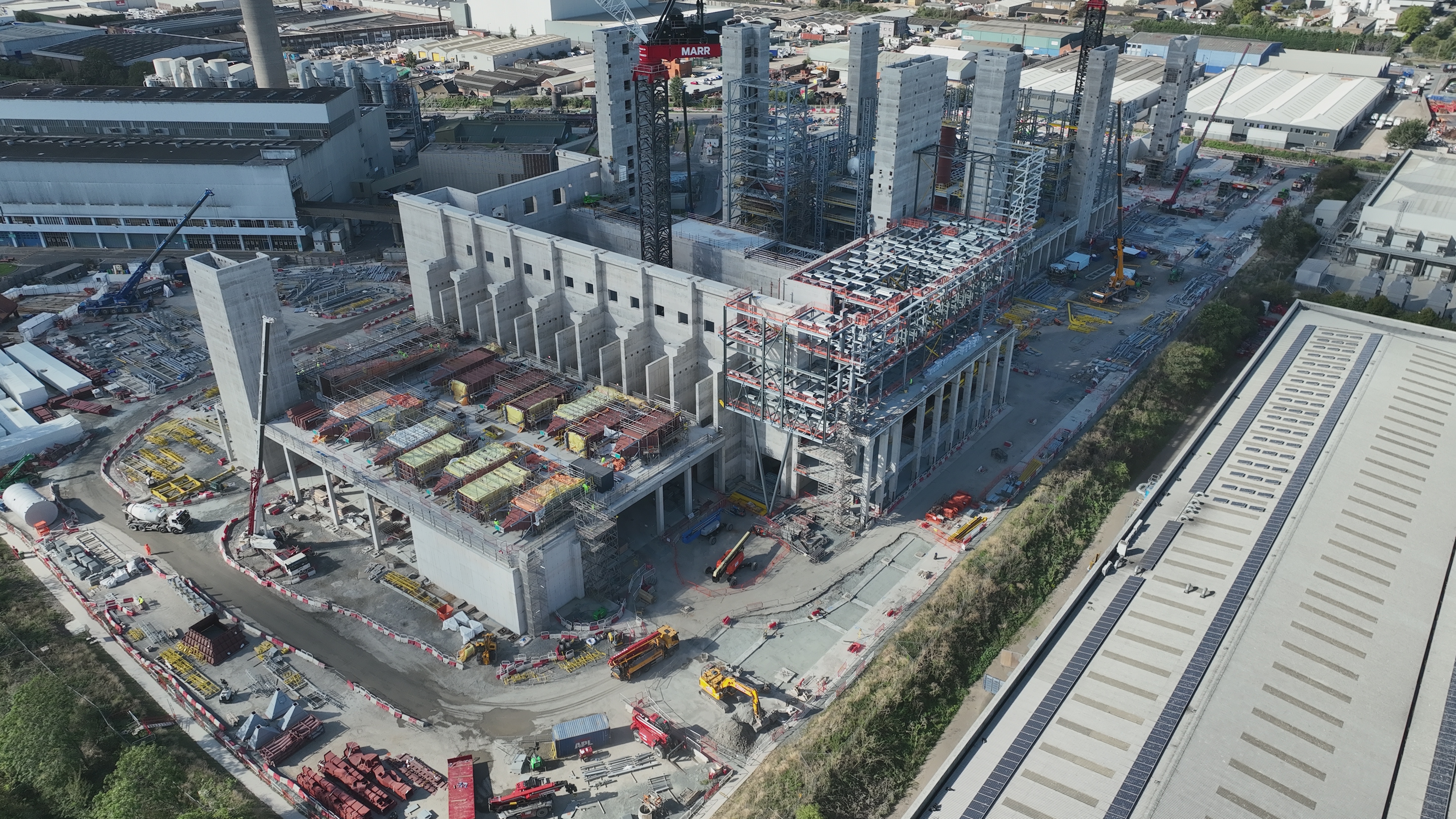

We produce construction update videos to show the progress being made on-site to deliver the NLHPP. To view the latest construction update video please click here.

Over the next ten years we are building:

  • Energy Recovery Facility to generate low carbon energy from waste, in the form of heat and power.
  • Resource Recovery Facility with an area to process bulky waste and prepare materials for energy recovery, including a:
  • Reuse and Recycling Centre, for use by the public, and
  • EcoPark House on River Lee Navigation including a visitor and education centre.

The project timeline can be viewed here.

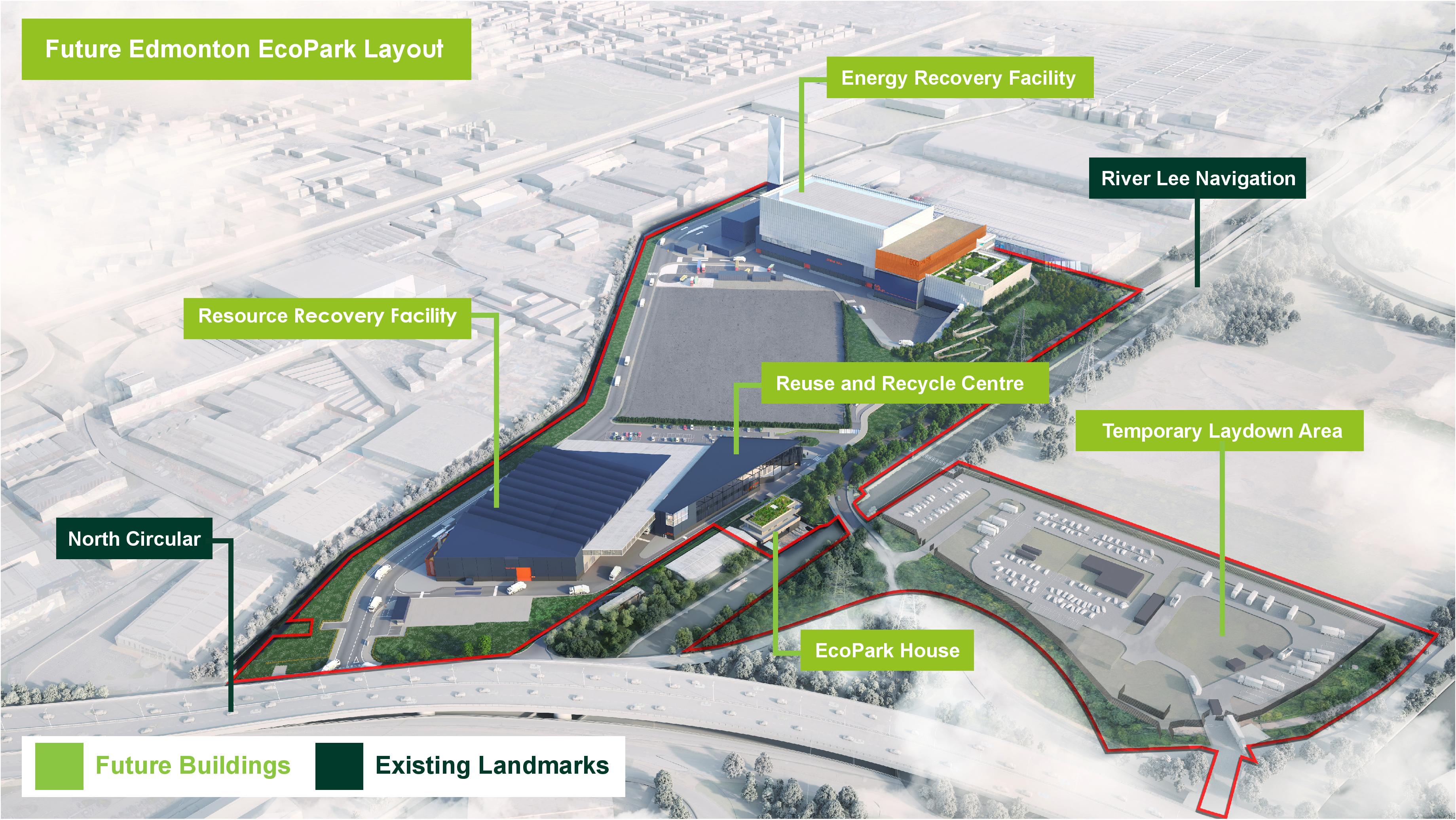

What will the site look like?

This design:

  • delivers the facilities required to manage north London's waste.
  • creates new site access points.
  • ensures the existing plant can operate up until the replacement facility is operational.
  • provides space for a visitors' centre in EcoPark House near the River Lee Navigation.
  • responds to consultation feedback with a modern design aiming to reduce visual impacts.
  • provides space for landscaping Edmonton EcoPark upon completion.

Generate 78 megawatts of power from waste which can supply electricity and heat for up to 127,000 homes.

Save the equivalent of 215,000 tonnes of CO2 every year using energy recovery rather than disposing to landfill. That’s like taking 110,000 cars off the road.

Improve air quality in north London with a current plant that operates 20% better than the permitted levels of nitrogen oxide and the new facility performing at more than 60% better.

Support an impressive programme for over 100 apprenticeships and 225 skills training opportunities for the local community.

Create over 2,500 job opportunities during construction and operation, further boosting the local economy.

Treat waste for over 2 million residents in the most cost-effective way.

Project Timeline

November 2014

Public Consultation on plans

The consultation with local community and stakeholders included two stages involving 15 public exhibitions, as well as community leaflets to over 28,000 homes, advertisements in the local press, letters to stakeholders and approaching all schools within a 1.5 km radius.

February 2017

Development Consent Order granted

A Development Consent Order to build a new energy recovery facility, and associated development at Edmonton EcoPark, was approved by the Secretary of State for Business, Energy and Industrial Strategy on 24 February 2017.

July 2018

Procurement of the contractors begins

January 2019

Prepare the Laydown Area and Eastern Acess for the site

Formation of a temporary laydown area to the east of the existing site and improvement works to Lee Park Way

August 2019

Prepare the Northern Access for the site

Improvement works to Deephams Farm Road, which is north of the site and leads via Ardra Road and Meridian Way.

November 2019

Drone footage of Edmonton EcoPark

Drone footage taken by Site-Eye that shows the current facility at Edmonton EcoPark.

December 2019

Prepare the southern area of the site

The new Resource Recovery Facility will be constructed over the existing Angel and Chingford sewers and a diversion of the sewers, including the construction of new manhole access points, is required to maintain access and allow the facility to be constructed over the sewers.

October 2020

Construction of Resource Recovery Facility and EcoPark House

EcoPark south works to build the flagship centre for increasing recycling know as the Resource Recovery Facility which includes a new public Reuse and Recycling Centre for local residents. The works also include a new education and community centre call EcoPark House.

May 2022

Construction of the Energy Recovery Facility

Construction of the world-class facility to generate low carbon energy from waste, in the form of heat and power commences.

July 2022

Prepare the northern area of the site

Demolition and clearance of the existing Bulky Waste Recycling Facility and Fuel Preparation Plant located at the north of the existing facility after operations have moved to the Resources Recovery Facility.

June 2023

Resource Recovery Facility and EcoPark House construction commissioned

The North London Heat and Power Project is North London Waste Authority’s proposal to build an Energy Recovery Facility with associated buildings and works.

January 2025

Energy Recovery Facility construction commissioned

The Energy Recovery Facility will be fuelled by up to 700,000 tonnes of non-recyclable waste each year, enough to power up to 127,000 homes and providing heat for a district heat network.

January 2027

Existing plant decommissioned and demolished

Decommissioning, demolition and removal of the existing Energy from Waste plant at Edmonton EcoPark.

January 2030

Final Site Works
